About PM MITRA Amravati
- Land area: 1020 acres (~4.13 sq. km)
- Project cost: INR 1,492 Cr (~166 USD million)
- GoI grant: INR .Cr (m USD)
- Implementation model: Brownfield SIA (MIDC)
- Industrial plots: 620 acres
- Plug-and-Play Units: 74.2 acres
- Water Supply and Drainage
- Power Infrastructure
- Solar Power Plant
- Direct jobs: 50,000
- Investment: INR 6000+ + Cr (723 M USD)
- Sustainability rating: coming soon
- Power: Rs 4.5 / unit
- Water: Rs 25 / KL
| • CETP (10 MLD) | • STP (2 MLD) with Sewerage | • Training Centre |
| • Workers’ Accommodation | • Plug & Play Units | • Administrative Office |
| • SCADA |
Connectivity
30 km
Mumbai–Nagpur
Expressway
25 km
Amravati
Railway Station
42 km
Amravati
Airport
697 km
Jawaharlal Nehru
Port
N/A
N/A
The PM MITRA Amravati Edge
Land
Fully planned trunk infrastructure including roads, drainage, power, water, and common amenities.
EoDB
EC and DTCP approvals in place
Entreprenuurial ecosystem
- Existing Ecosystem: 14 major textile parks comprising ~631 individual textile units operating within a ~200 km radius of the park
- Institutions: Textile Commissioner of India (Mumbai); 7 major textile councils/associations based in Mumbai; The Bombay Textile Research Association (BTRA)
Sustainability focus
10 MW Ground Mounted Solar Plant with Energy Storage.
Facilities
- Applications invited for land allotment
- Land available through MILAAP portal
- External approach road available
- Internal roads under construction

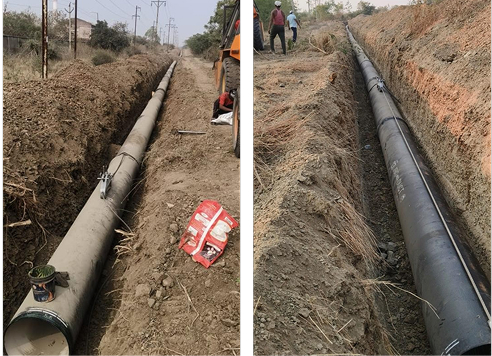

- External water supply pipeline under construction
- Basic water infrastructure available on site
- Power infrastructure available
- Infrastructure development works in progress

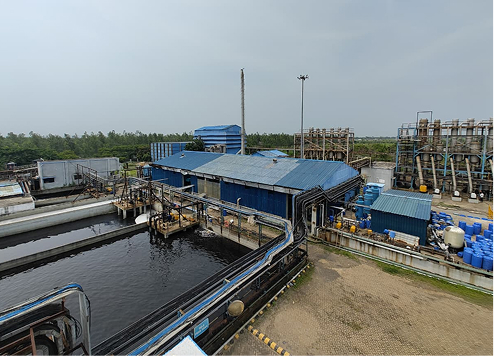

- 5 MLD CETP available, being upgraded to ZLD
- 15,000 CBM effluent sump completed
- Effluent collection system 80% complete
- Tenders worth ₹221.73 Cr issued for Phase-I infrastructure including Plug-and-Play facilities
- Infrastructure works worth ₹180 Cr under implementation
- Skill Development Centre – construction completed
- DPR approved on 17.10.2025 by Park Committee
- First grant-in-aid installment of ₹30 Cr approved
- ₹135.32 Cr expended so far
- Basic infrastructure for roads, power and water available on site
Conducive Policy
- 40% of the basic cost of eligible machinery, up to INR 25 Cr
- Investment > INR 1,000 Cr and employment ≥ 2,000
- 55% capital subsidy up to INR 250 Cr
- Special package approved by High Power Committee (HPC) chaired by the Chief Secretary
- Investment > INR 100 Cr and employment ≥ 1,000
- Large Projects: 45% capital subsidy of total project cost
- Eligible for capital subsidy benefits under the policy framework
- Recycling of Old Textile Products: Subsidy @ 50%, up to INR 2 Cr, for new projects set up exclusively for recycling
- Renewable Energy / Solar Projects: Capital subsidy equivalent to 12 months of electricity subsidy for solar energy projects
- Fund for the promotion of research and development

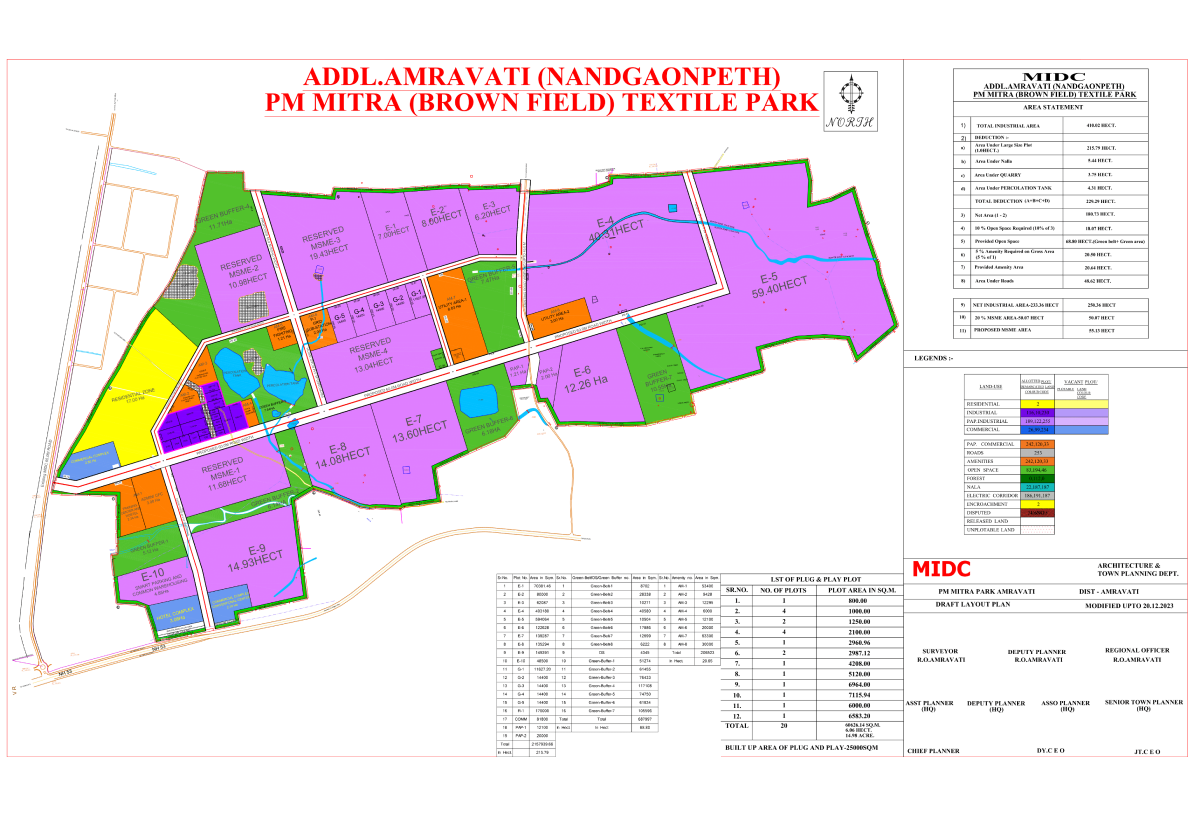

Layout
Meet Us At
Investor Summit
Engage with PM MITRA representatives at official investor summits to explore opportunities, policies, and land allotment details.
Invest India
Access comprehensive information on Maharashtra investment ecosystem through Invest India's official state portal.
Road Shows
Connect with PM MITRA and Maharashtra officials at national and international roadshows showcasing investment opportunities.
For any queries connect with us
Dr. P. Anbalgan, IAS Secretary
Shri. P Velerasu, IAS
Lets Get Started With Your Enquiry
Submit your enquiry and our team will get back to you shortly.
